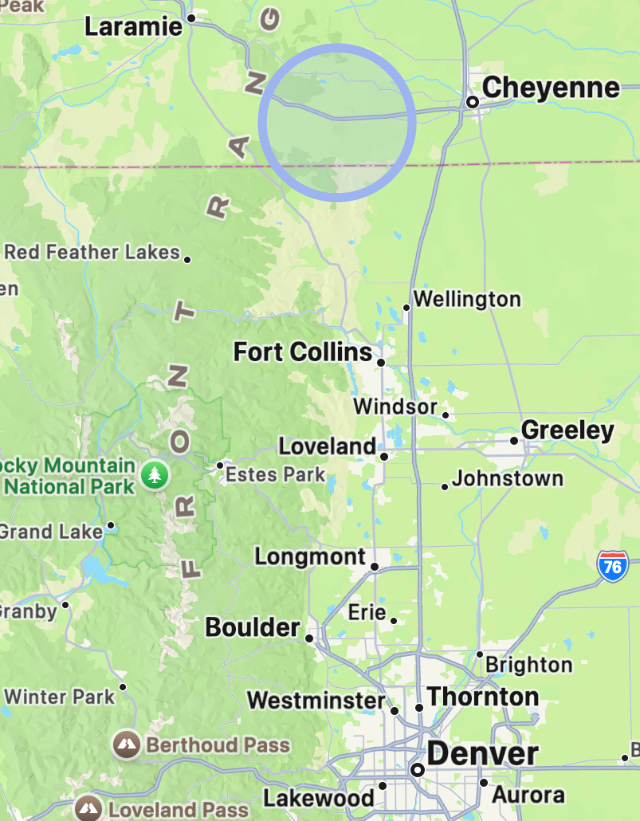

Site control available today, with a pathway to a $3.1B data center campus. ±323 acres outside Cheyenne with three interstate gas pipelines crossing it.
Laramie County, Wyoming·On I-80, ~20 minutes west of Cheyenne
Assumptions
Three cases, each with its own buildable acres, density and cost per MW. Pick one, and everything recalculates.
Base case assumptions
Buildable acres and density vary with the end user's site plan and building plan.
Buildable acres
Density (MW per acre)
All-in build cost per MW
Excludes chips and GPUs.
Density moves capacity most
Across the three cases, density swings 50% (1.0 to 1.5 MW per acre); buildable acres swing 8% (240 to 260).
Density is MW of data center load per buildable acre. 1.0 MW per acre is the lowest we've heard from market participants; the top case uses 1.5 MW per acre.
Public campuses pencil at roughly 0.9 to 2 MW per gross acre: Meta's Louisiana campus, ~2 GW on 2,250 acres (~0.9); Crusoe's Abilene campus, 1.2 GW on ~1,100 acres (~1.1); JLL puts 1 GW-plus campuses at 500 to 800 acres (1.25 to 2.0). Our cases are stated per buildable acre; on 323 gross acres the top case reads ~1.2 MW per gross acre.
From 323 acres to the three cases
±323 acres surveyed, less the access road strip (~24) and the pipeline corridor easement (~31.5) leaves ~264 buildable on the pre-survey shading plan.
The cases sit below that on purpose: 260 is the plan, 250 the base, 240 the low case, leaving room for setbacks, drainage, geotech and topography.
All estimated until the ALTA survey (due Nov 4) and the stamped exhibit. Title and survey are on order.
Cost per MW
All-in to build, excluding chips and GPUs: $9M, $10M and $11M, with $10M the base. A lower cost means a smaller tax savings, so the conservative case uses the lowest.
Source: Cushman & Wakefield, Data Center Development Cost Guide 2026: $8.9M–$23.3M per MW across the U.S. and Canada, with Cheyenne in the lower-cost third of its 38 markets.
Capacity
Project cost: capital investment
The Timeline
Rezoning, Gas and Grid
Rezoned Q1 2027. County Commissioners vote February 2, 2027. Agricultural to PUD, which allows data center use.
11–13 months to gas at the site. The clock starts at a signed agreement and funded deposit.
Grid at campus scale in 5+ years. Application filed with the utility.
Swipe the chart to see the full timeline →
Q4 2026Q1 2027Q2 2027Q3 2027Q4 2027Q1 2028
Rezoning Laramie County · running now
Oct 5 · Commissioners briefing
Nov 6 · PUD submittal
Jan 14 · Planning Commission
Feb 2 · Commissioners vote: rezoned
Gas buyer-triggered
Buyer signs and funds (illustrative; the buyer sets this date)
11–13 months to gas at the site
Grid campus scale
5+ years →
Planned dates; the county sets hearing dates. A local planning team and local counsel are working it with county staff.
Two Unanimous County Approvals
For gas-powered data center campuses in 2026
January
A 1.8 GW data center campus, scalable to 10 GW, with a co-located 2.7 GW behind-the-meter gas plant, about 8 miles south of Cheyenne.
September
A PUD rezone for an 1,835-acre, 480 MW gas-powered campus, about 12 miles south of Cheyenne.
Different developers, different sites, the same answer.
What the County Gains
Property Tax
a year, first year
County Tax Base
added to the county's entire tax base
Construction
jobs at peak
Estimate, scaled from a county precedent
Permanent
jobs ongoing
Estimate, scaled from a county precedent
How the property tax estimate works
Taxable value assumed at 70% of project cost
Assessed at 11.5%, the level for industrial property
Times 65.54 mills, the 2025 total for rural School District 1 tax districts with a fire district
First year shown. Equipment depreciates, so the bill steps down between hardware refreshes and back up with each one
The county assessor sets the real classification and value
How the jobs estimate works
Construction jobs scaled per MW from the January 2026 county approval, which cited 5,000 construction and 400 permanent jobs at 1.8 GW
Permanent jobs shown at about half that precedent's ratio, a deliberately conservative estimate
Laramie County Board of Commissioners hearing record, September 1, 2026
What the Site Offers
Site Control
Ready to assign today.
Purchase option, freely assignable without seller consent.
Executed and recorded, September 2026.
The buyer closes directly with the landowner.
Open to term sheets anytime.
Gas · 11–13 Months
A mainline corridor, not a single-pipe site.
Capacity indicated in writing by three interstate operators.
Three interstate operators, three separate lines — gas supply options for the buyer.
Four interstate lines in the corridor — three cross the parcel.
Grid · 5+ Years
Construction power nearby; campus scale later.
34.5 kV distribution tap about 1,000 ft from the parcel, for construction power and station service.
Application filed with the serving utility.
Large-load study queue scheduling into Q2 2027.
Construction begins once the end user signs service, interconnection and generation agreements.
Wyoming Tax Savings
Initial Build
Each Refresh
new hardware, every 4–5 years
The Wyoming exemption
Wyoming exempts qualifying data center equipment from sales and use tax, for data centers that meet the state's investment thresholds.
Servers, networking gear and the supporting infrastructure that goes into a qualifying facility are not taxed on purchase.
Qualification is based on investment size, with thresholds starting at $5M in capital infrastructure and $2M in qualifying equipment.
These figures estimate what that saves a buyer on this site. Confirm with tax counsel.
How the estimate works
Assumes each case's cost per MW ($9M, $10M or $11M) and ~60% in qualifying equipment: roughly $338K, $375K or $413K of savings per MW, applied to the MW in the case shown.
It moves with the case shown. A buyer's actual build plan sets the real number.
Data Centers in Cheyenne
Data centers in and around Cheyenne:
10operating
5being built
10planned
Meta is building in Laramie County: $800M, 715,000 sq ft on a 960-acre parcel south of Cheyenne, online 2027.
On a transcontinental fiber route, about 100 miles from Denver.
Data center counts and fiber per Cheyenne LEADS.
Interested in more details about this project?
Operators, capacity position and the full diligence package are shared under NDA.
